Fill in the blank with the appropriate word. ____ management sets the boundaries for the project and is the foundation on which the other project elements are built.
You are the project manager for your organization. You are working with your project team to create activity duration estimates using the PERT method. What is the formula for PERT?

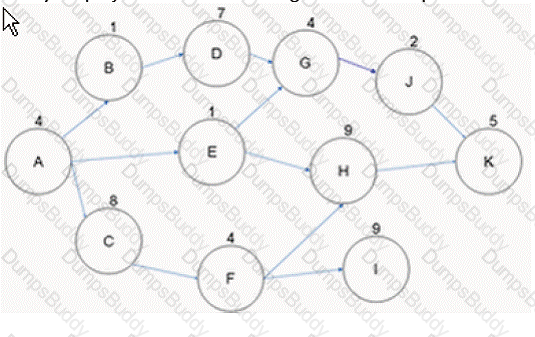

Examine the figure given below:
If Activity B takes eight days to complete instead of five days as schedule, how long can you now delay Activity H?
Holly is the project manager of her project. She has chosen to crash the project due to time constraints that have been imposed on her project. When Holly crashes the project what project document must be updated to reflect this change to the approach?
Lily works as a project manager for BlueWell Inc. She has recorded the following duration estimates for an activity in her project: optimistic 35, most likely 50, and pessimistic 95. What time will she record for this activity?
Which organizational theory explains the factors that promote performance of people in any organization?
Which of the following documents is a narrative description of products or services to be supplied by the project and has detailed requirements and pricing specified on it?
Jack works as a project manager for the NHQ project. His project has a budget of $2,208,456 and is scheduled to last for three years. His project is currently forty percent complete though it should be forty-five percent complete. In order to reach this point of the project, he has spent $725,000. Management needs a performance report regarding the NHQ project. Management is concerned that this project will be over budget upon completion. Management would like to create a report telling them how much more the project will need to complete. What value should Jack tell the management?
You are the project manager of the NHQ Project. Management has set a conformance to the project schedule for your project at 0.95. What does this term mean?
John works as a project manager for BlueWell Inc. He is working on a high-profile project with 80 stakeholders and he needs to express to his project team and to the management the importance of communication in the project. He would like to show the number of stakeholder communication channels in the project. Based on this information how many communication channels exist within this project?
Amy is working on a project which is forty percent complete though it was scheduled to be fifty percent complete as of today. Management has asked Amy to report on the schedule variance for her project. If Amy's project has a BAC of $750,000 and she has spent $485,000 to date, what is the schedule variance value?
Fredrick works as a Project Manager for BlueWell Inc. A number of projects are running under his guidance. You, a team leader of a project, inform Fredrick about the performance indexes of your project. The schedule performance index (SPI) of your project is 1.325. What does this figure indicate?
Jim is the project manager for his project. He and his project team are creating their duration estimates for the work packages in the WBS. For each activity, Jim is adding a few hours to the duration estimate in case something goes wrong during the completion of the work activity. Sarah, the project sponsor, does not approve of this and warns Jim of Parkinson's Law. What is Parkinson's Law?
You have been assigned to a project that centers on a discipline you are only topically aware of. While you do have years of experience as a project manager, but you have never worked with the technology, as is in this project. During the define activities process, you rely on your project team and two consultants to coach you and identify the type of activities the project will include. Which tool and technique are you using in the define activities process in this scenario?
You are the project manager of the AHQ project. This project is scheduled to last for six months and will require $345,000 to complete. If the project completes earlier than scheduled, your organization will receive a bonus of $5,000 per day of early completion. Management has asked you to develop an aggressive schedule to realize as much of the bonus as possible, but management does not want you to increase the costs of the project beyond $1,000 per day of the bonus realization. Which of the following approaches will likely add costs to the project?
John is the project manager for his organization. He has created a status dashboard for his stakeholders. What is a status dashboard?
You are the project manager of the GHT Project. Ben, one of your project team members, does not understand the idea of a milestone. Which of the following best describes what a milestone is?
You are the project manager of a project that has a budget of $675,000 and you have completed 40 percent of the project work. Your project is supposed to be 60 percent complete but you are actually only 40 percent complete. Due to some errors, however, you have actually spent $335,000 of the budget. Management wants to know what the project's cost performance index (CPI) is. What value do you report?
You are working as a project manager for BlueWell Inc. Which of the following tools and techniques of the Define Activity process will help you in identifying the typical schedule milestones?
You work as a project manager for BlueWell Inc. Management has asked you not to communicate performance unless the CPI is less than 0.96 or the SPI dips below 0.98. What type of report would you create for management, if these instances develop in your project?
John works as a Project Manager for Blue Well Inc. He is measuring cost efficiency of his project. The key values are provided in the table below:
What is the cost performance index (CPI) of the project at the current point of time?
You are the project manager for GGY Project. You are working with your project team to record the actual durations for the activities they have completed in the project schedule. Mary, one of your project team members, wants to know why you need to know how long it actually took the project team to complete their assignments as long as the project work is completed. Which of the following is the best response for Mary's query?
You are the project manager of the NGG Project. This project will be using a new material that the project team has never worked with before. You'd like to use some preventive action to ensure that the installation of the new materials is successful in the project. Which one of the following project actions is an example of the best preventive action for this project?
Harry works as a project manager for BlueWell Inc. A risk that has been identified and analyzed in the project planning processes is now coming into fruition. Who among the following is responsible for implementing the risk responses or contingency plan?
Steve is the project manager for the POK Project. He is working with the project customers to determine how frequently they'd like to receive the project information. The customers would like weekly status reports on how the project is performing. Where should Steve document this information?
John is the project manager for his organization. Management has asked John to fast track his project in order to reach a particular date for the project completion. When John fast tracks the project what project management component must be updated to reflect this decision? Choose the best answer.
If you are the project manager of the BNQ Project and you add "waiting time" between two activities, then what have you added in the project?
Holly is the project manager for her organization. Her current project is running late and her project customer has asked Holly to find a method to apply corrective actions to the project schedule. Holly is exploring the concept of crashing the project. Which of the following statements is true about crashing the activities in Holly's project?
You are the project manager for your organization. You have been recording the actual results of activity duration for your project. Many of the results are late and this is causing your project to be late on reaching its milestones. What tool and technique can you use as a part of controlling the schedule to help you review various scenarios to bring the schedule into alignment with the plan?
You are the project manager of the SWC project. You have created the stakeholder register. In the stakeholder register of your project, you will have all of the following information except for which one?
Which of the following provides a method to track project progress during project execution against what was planned?
Jeff is the project manager of the GHY Project for his organization. He has created the project network diagram as shown in the figure:

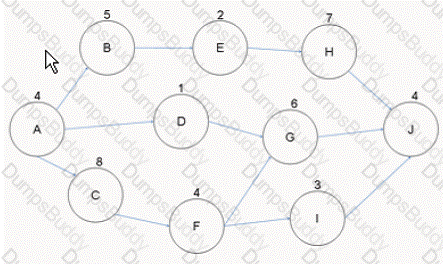

Management is reviewing the network diagram, and they are concerned about the latest date that Activity I can finish. What is the latest day Activity I can finish without affecting the project end date?
Frank is the project manager of a construction project. In this project, Frank has elected to allow the interior design phase of the project to overlap with the pool construction phase of the project. Normally, Frank would not allow these two phases to overlap, but for this project, he has elected to do so in order to compress the project schedule. What is this schedule compression technique called?
In which of the following process groups does Integration Change Control Process fall?
Gary is the project manager of the NGH project for his organization. He and the project team have created the initial WBS. Before Gary and the project team begin creating the activity list, Gary wants the project team to help him create a unique numbering system for the deliverables identified in the WBS. What numbering system can Gary and the project team apply to the WBS to identify the components of the WBS?
You are the project manager of the GHY Project. This project is scheduled to last for one year and has a BAC of $4,500,000. You are currently 45 percent complete with this project, though you are upposed to be at your second milestone, which accounts for half of the project completion. There have been some errors in the project, which has caused you to spend $2,073,654. Based on the estimate at completion, what is this project's to-complete performance index?
You work as a project manager for BlueWell Inc. Management has asked you to communicate with them whenever your project is about to reach a milestone so that they can review your project performance to date. Where can you find a list of the project milestones to anticipate management's request?
You are the project manager of the NHQ Project. This project has a Budget at Completion of $750,000 and is expected to take 18 months to complete. The project is supposed to be 75 percent complete, but due to some errors the project is only 60 percent complete. At this time the project has spent $465,500. Management has asked you to review the project work and report the project's SPI. What is the SPI for this project?
You are the project manager for your organization. Management has offered you a bonus if you can complete the project work two months earlier than what your schedule predicts. You can use a schedule compression technique, but management does not want to increase costs in the project. What approach would you recommend to condense the project duration?
John is a scheduler in ABC Company. He has to plan an activity for the schedule models. Which of the following activities will he use to make the schedule models? . Each correct answer represents a complete solution. Choose all that apply.

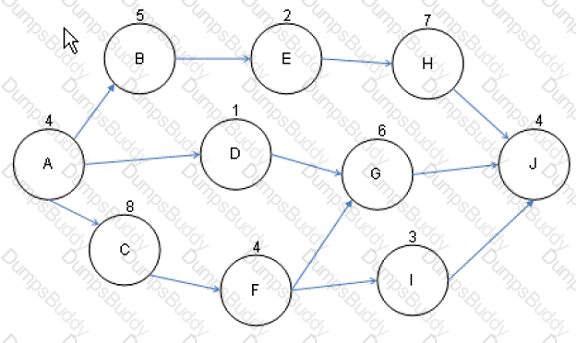

You work as a project manager for BlueWell Inc. By referring to the figure given below, you along with your project team is calculating the latest completion of an activity.
What is the latest your project team can complete Activity I?
You are the project manager of a software development project. Your project team will be creating a web-based software application that will allow your company's customers to browse your website, search inventory, and place orders among other things. Your project team will, on a regular basis, need to update their computer virus prevention software, update their operating systems, and perform other maintenance on their computers in order to complete the project. This maintenance work is not directly tied to the project deliverables, but it is needed in order for the project to be completed. What term best describes this maintenance work?
Donna's project has a budget at completion of $1,987,560 and she is currently 40 percent complete. Her project schedule called for her to be 45 percent complete but there have been some complications in the project. These complications have caused Donna to spend $125,000 more than what the work she has completed is worth. Based on this information what is the cost performance index (CPI) for Donna's project?
You are the project manager of the NHQ Project and are trying to determine which seller you should choose for the project. You have received proposals from six vendors and they are all very good proposal, qualified to complete the project work, and the prices are close to the same. You would like to create method of ranking each vendor based and assign a score value to several different categories. Because the project is a high-profile project, you have assigned 25 points to experience and 10 points for all of the other categories to judge the vendors. This is considered what type of source selection process?
You work as a project manager for BlueWell Inc. You must communicate on a regular basis with all of your project stakeholders. In your project, you have 755 stakeholders. How many communication channels exist in the project?
